Hostel Project for Students of the College of Medicine, University of Ibadan (CoMUI) Administered by the
Ibadan College of Medicine Alumni Association (ICOMAA)
Construction Activity Reporting Schedule: 27th Report
Date: 13th August 2024.
Site Construction Activities

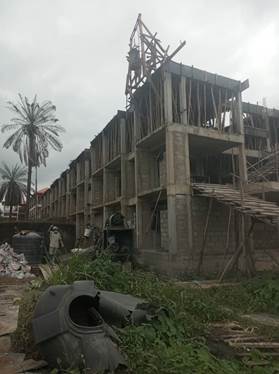

Block C (Philip Ozuah Block)

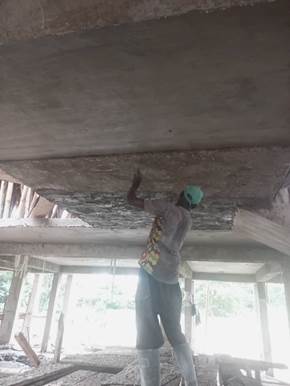

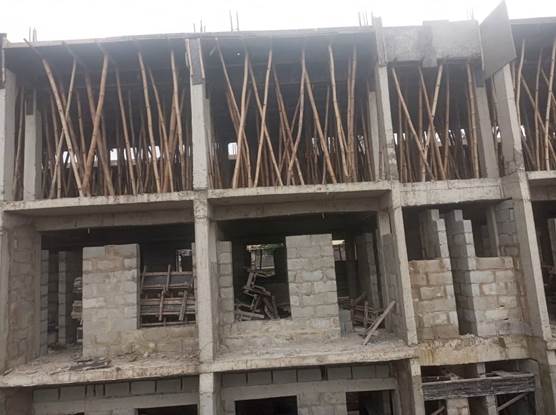

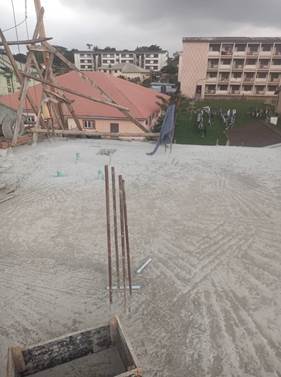

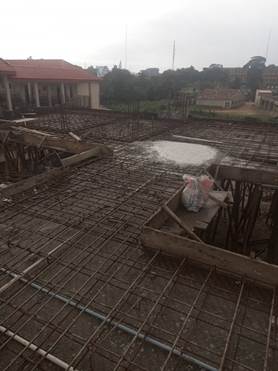

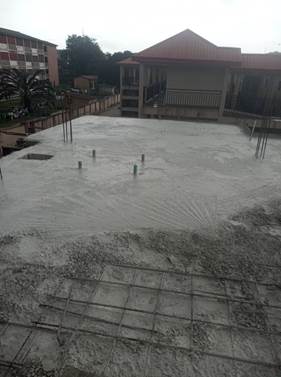

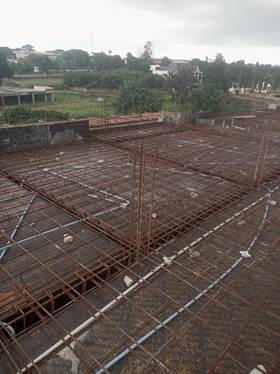

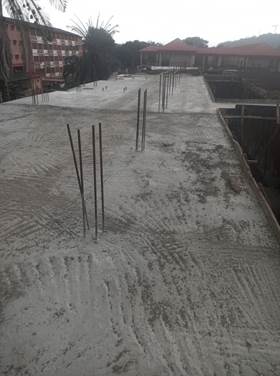

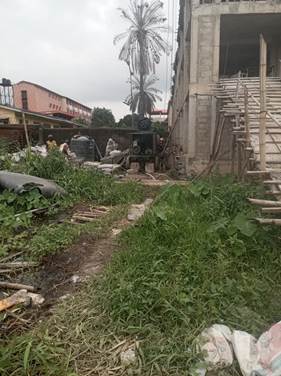

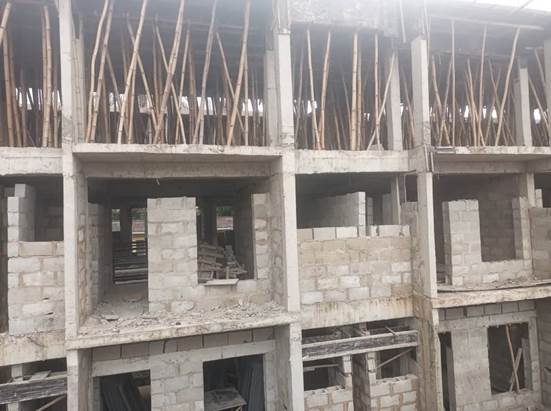

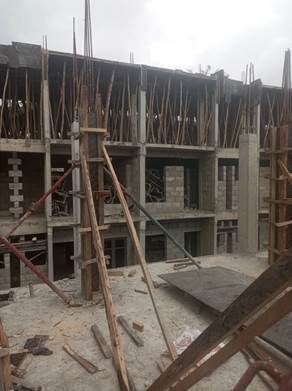

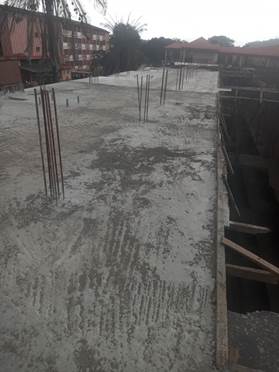

Update: The casting of the third-floor concrete slab is ongoing.
Timeline: As of 5th of August - 9th of August, the third-floor slab casting has reached 45% completion.
Challenges: There are no significant challenges in the construction works of
this block.
Pictures of Work done on site
_files/image002.jpg)
_files/image004.jpg)
_files/image006.jpg)
_files/image008.jpg)
_files/image009.jpg)
_files/image010.jpg)

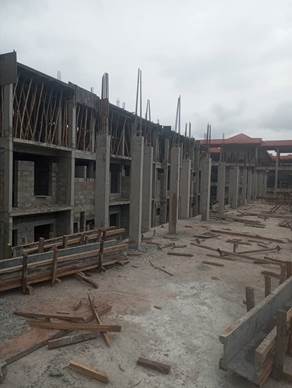

Block D (TY Danjuma Block)

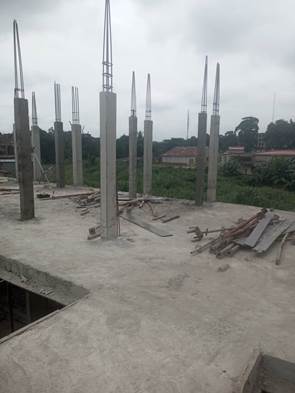

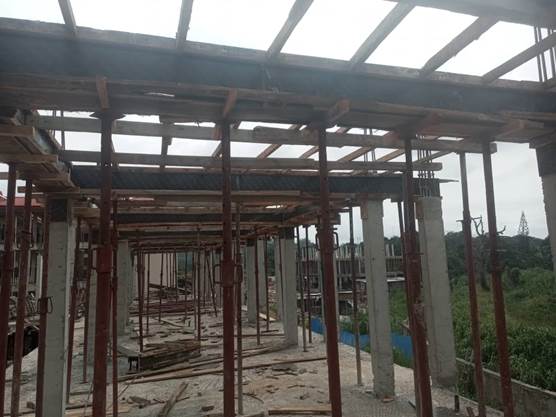

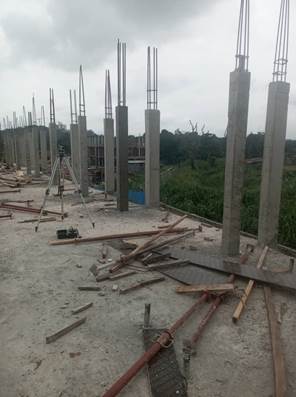

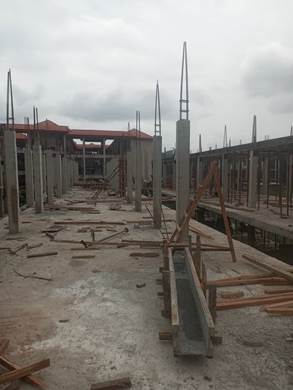

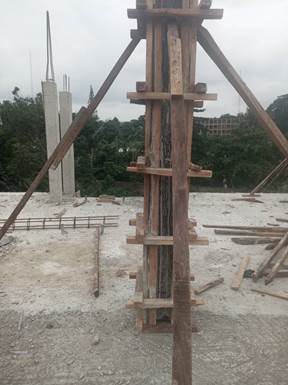

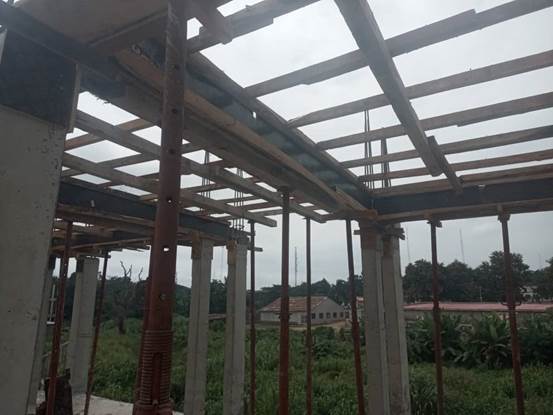

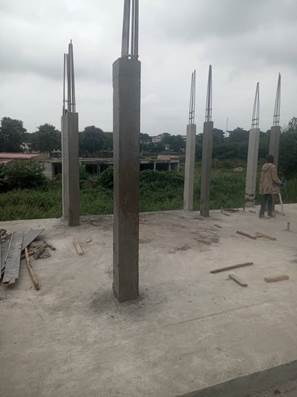

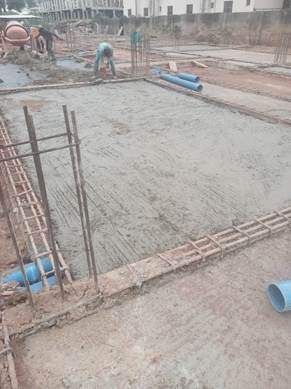

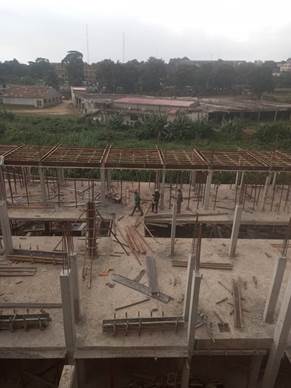

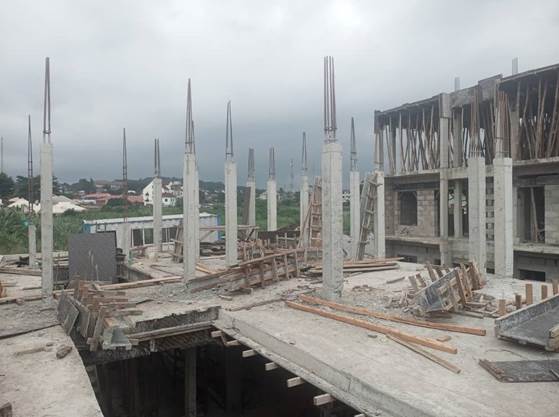

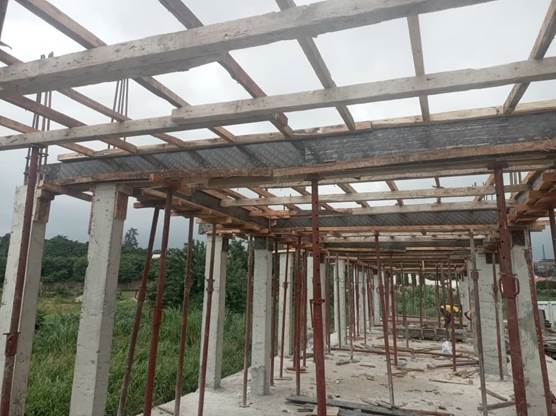

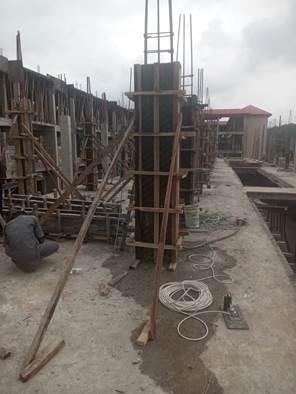

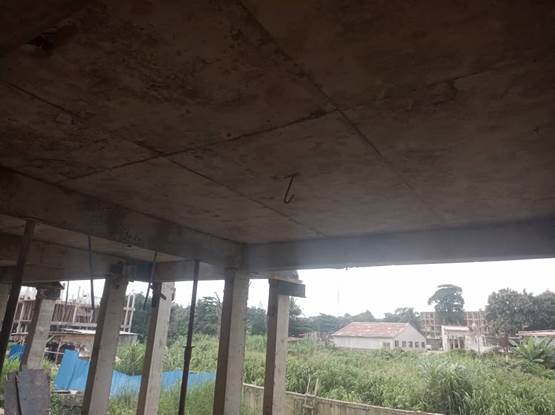

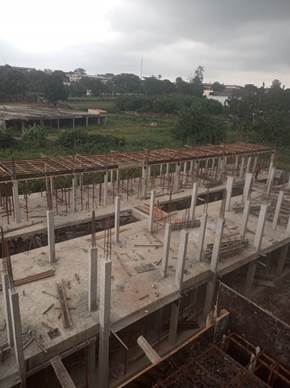

Update: The casting of the concrete columns to support the second-floor slab is ongoing.
Timeline: As at 5th of August - 9th of August, the program of work is being followed.
Challenges: There are no significant challenges in the construction works of this block.
Pictures of work done on site
_files/image012.jpg)
_files/image014.jpg)
_files/image016.jpg)

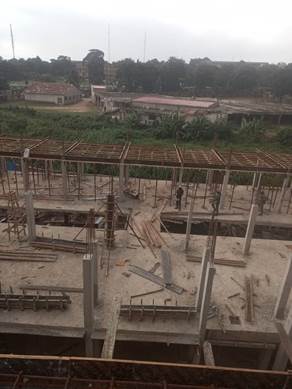

_files/image018.jpg)
_files/image020.jpg)
_files/image021.jpg)
_files/image022.jpg)
_files/image023.jpg)
_files/image024.jpg)
_files/image025.jpg)

_files/image026.jpg)

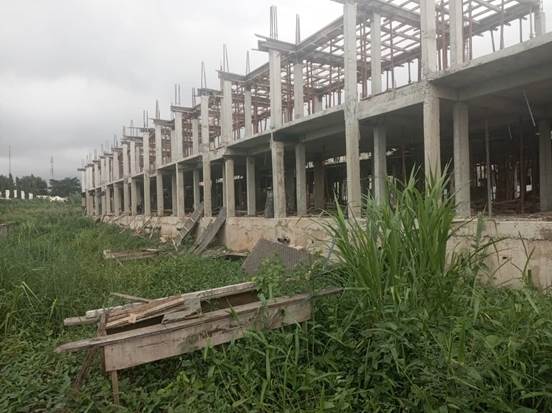

_files/image027.jpg)
_files/image028.jpg)

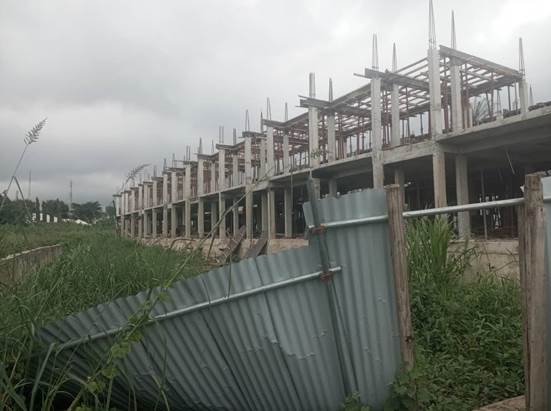

_files/image029.jpg)
Block E (Block)

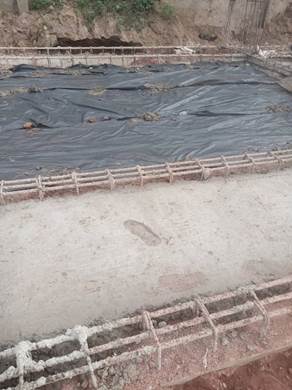

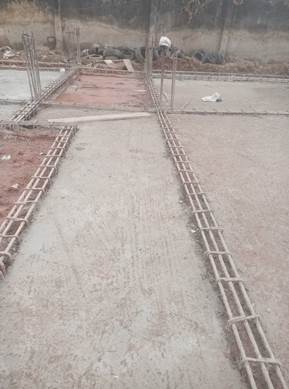

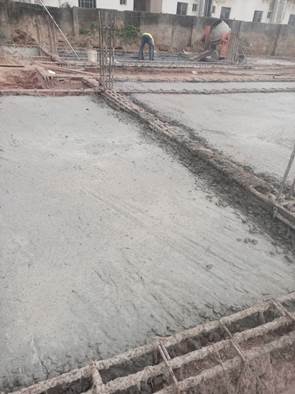

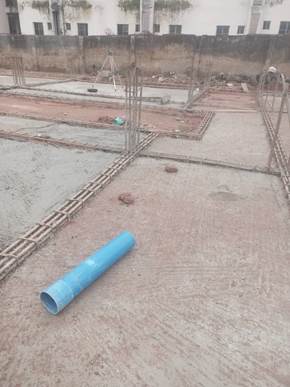

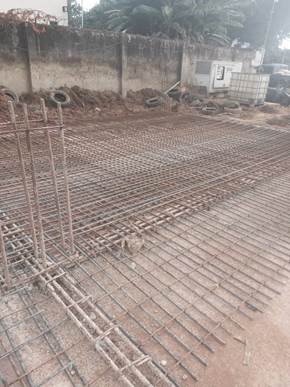

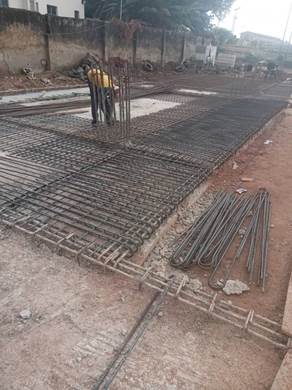

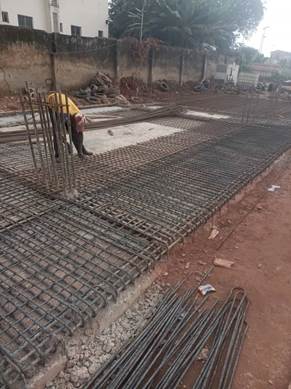

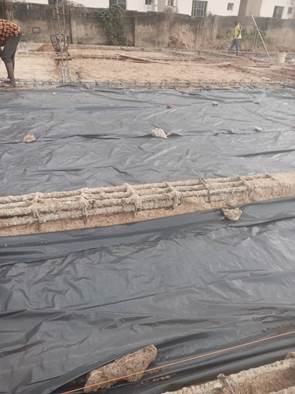

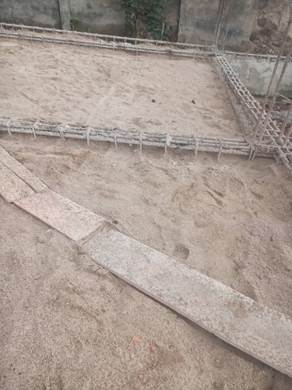

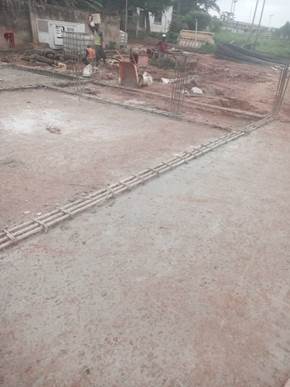

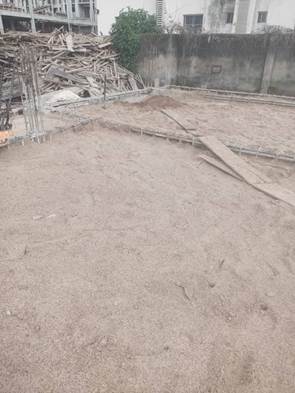

Update: The laying of the damp proof course membrane, blinding with weak concrete and placement of the steel reinforcement for the oversite concrete slab is ongoing.
TimeLine: As at 5th of August - 9th of August, the program of work is being followed.
Challenges: There are no significant challenges in the construction works of this block.
Pictures of work done on site
_files/image031.jpg)
_files/image033.jpg)
_files/image035.jpg)
_files/image037.jpg)
_files/image039.jpg)
_files/image041.jpg)
_files/image042.jpg)

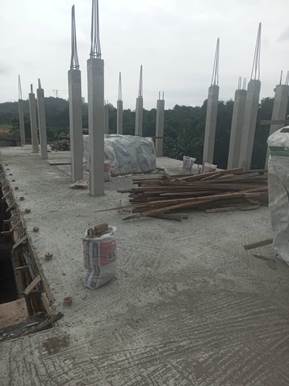

Block F (Alumni Block)

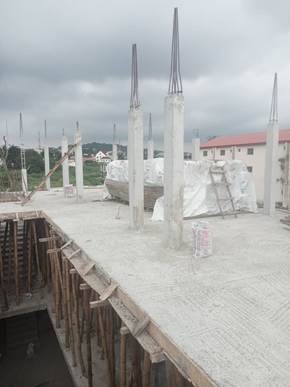

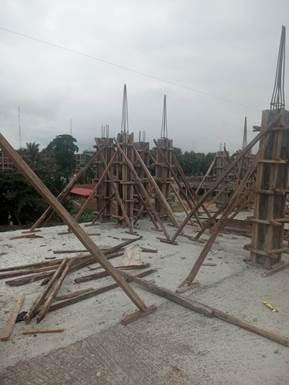

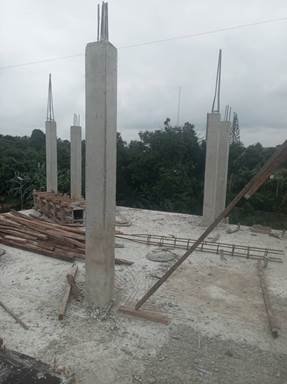

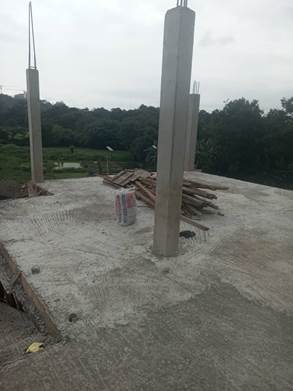

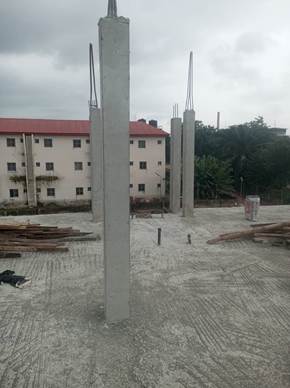

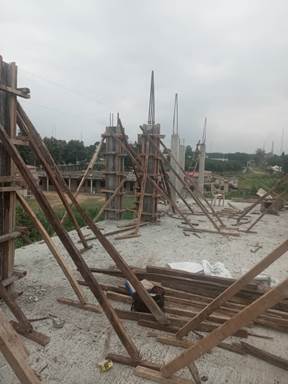

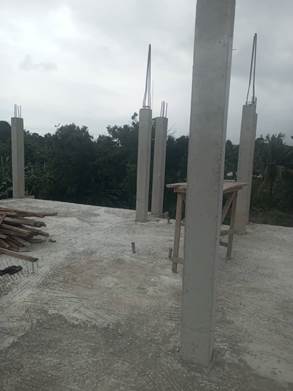

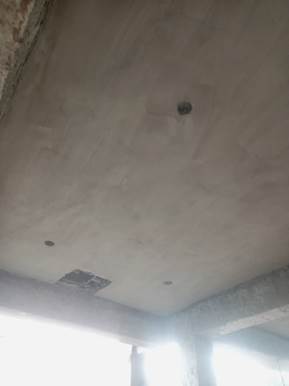

Update: The raising of the reinforced concrete columns to support the third-floor slab and beams is ongoing.
Timeline: As at 5th of August - 9th of August, the program of work is being followed.
Challenges: There are no significant challenges in the construction works of this block.
Pictures of Work done on site
_files/image044.jpg)
_files/image046.jpg)
_files/image050.jpg)
_files/image052.jpg)
_files/image054.jpg)

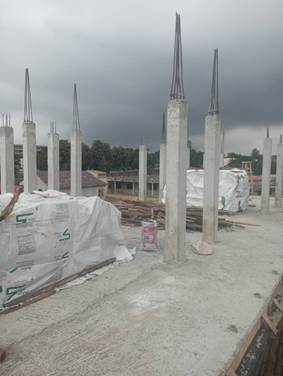

_files/image055.jpg)
Signed,
Arc. Dapo Ojo
Project Client Representative
Adapted for publication by
‘Seun Abimbola
Media Officer
